•  District Office Child Development Center - Classroom Additions (Summer 2017 - Spring 2018)

    3/17/2018 Update
    District Office Child Development Center - Spring 2018
    The construction work at the District Office Child Development Center is ecpected to be complete late March 2018. Concrete pathways are installaed and new perimeter fencing installation if underway. The parking lots will be striped and reopened for use the week of March 26, 2018.

    2/1/2018 Update
    District Office Child Development Center - Spring 2018

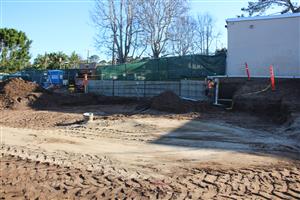

    The district is adding classroom space to acoomodate the growing special education program that serves preschool students and families. The room will be ready for occupancy April 2018. At that time, the west parking lot will be re-opened for daily operation. Foundation work is underway. A concrete retaining wall is being installed to assist with ADA access paths required on the site.

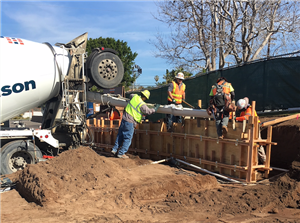

    Building pad    Concrete Pour for retaining wall


    District Office Child Development Center - Summer 2017
    The district will be replacing the three portable classrooms (14, 15, and 16) that are beyond useful life located in the middle of the property. The classroom work is scheduled to begin the week of June 26, 2017. The three classrooms will be replaced with five new classrooms, four of which are expected to arrive on site the week of July 17, 2017. Those four classrooms are expected to be ready for occupancy the week of August 14, 2017. Coastal Commission and CEQA environmental reviews are complete.
    12/21/2017 Update
    Umbrellas arrived and have been installed at the new tables along Rios Ave.

    New Classroom installation will start January 22, 2018. The most westerly parking lot will be closed for the duration of construction (expected through April 2018).

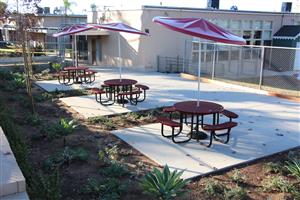

    Patio tables with umbrellas

    12/7/2017 Update
    Please be aware that the Fire Alarm at the District Office and Child Development Center will be tested on January 2nd at approximately 9:00 am. Expect to hear audible bells during the morning hours.

    We are please to complete the fencing, landscape and planting at the Old Building A site. Umbrellas will be installed once received.

    In the first quarter of 2018, the fifth new classroom will be placed just west of Building B. This is required to accommodate additional Special Education service needs. Expect site work to begin Late January with a completion scheduled for April 2018.

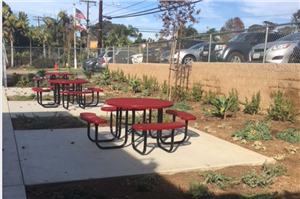

    Tables at District Office

    8/25/2017 Update
    The four new classrooms are now complete and ready for occupancy. Landscape is expected to be complete in time to welcome students on 8/29/2017.

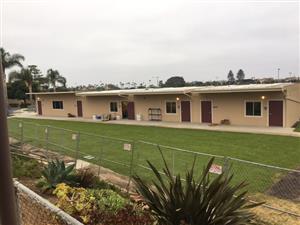

    four classroom buildings with landscape

    8/3/2017 Update
    The placement of the four classroom buildings is complete. Finishes are underway. Systems connections and testing will occur in the next couple of weeks.

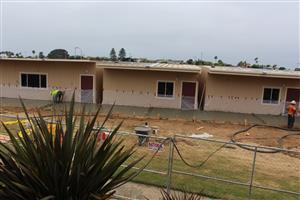

     Classroom buildings

    7/7/2017 Update
    The demolition of the three classroom buildings will continue through Friday, July 7, 2017.  Next week, work will include foundation grading and utilities (water, electrical, fire alarm, etc).

    7/3/2017 Update
    The demolition of the three classroom building began 7/5/2017. The cleanup and disposal is expected to take 4 days.


    Claw of Tractor over Building



    If you have questions regarding the construction projects - please call 858-794-3699 or email facilities@sbsd.k12.ca.us
